The CHALLENGE
At the heart of PTI’s production facility was an overhead crane approaching 100 years of service. When a major component failure took the crane out of operation, PTI was faced with a critical decision: invest in a rebuild of aging equipment or replace the entire system with a modern crane designed to meet current operational demands.
The challenge extended far beyond selecting a new crane.

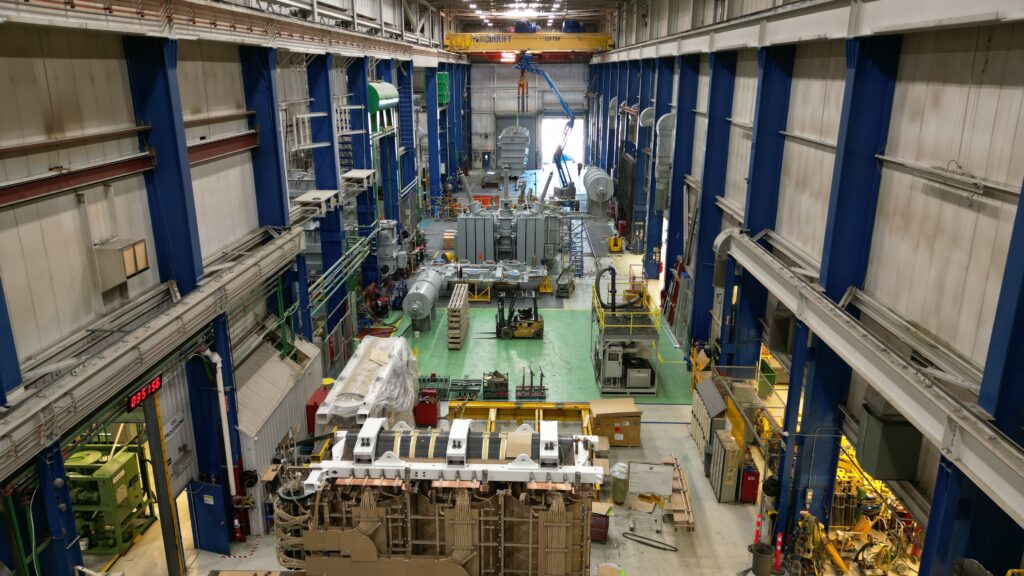

The existing system featured dual 51-foot bridge girders weighing approximately 35 tons each and operated at a hook height of 55 feet. Replacing the crane would require removing the existing system from inside an active manufacturing facility while minimizing disruption to production and maintaining strict safety standards throughout the project.

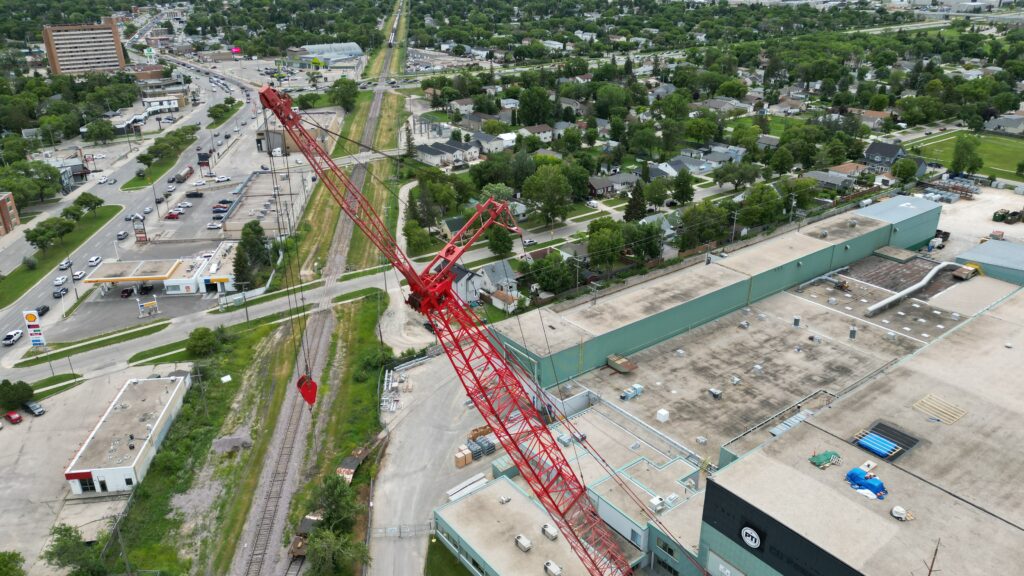

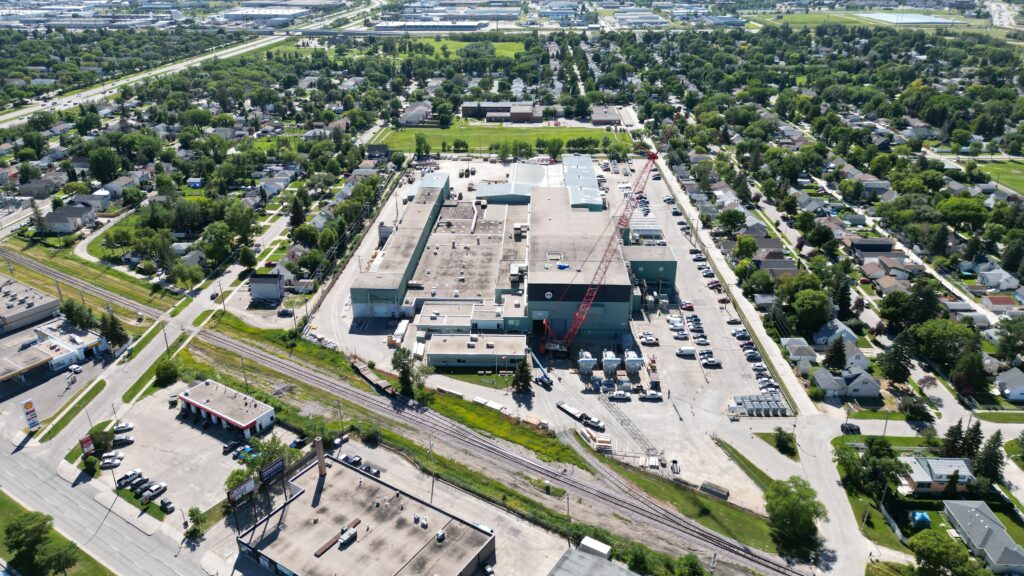

The complexity of the installation required detailed planning, coordination between multiple contractors, and precise execution. Sections of the building roof had to be removed to provide access for a 300-ton crawler crane. Working from outside the facility, the crane needed to reach approximately 70 feet into the building while operating alongside ongoing plant activities.
What could have been a significant operational disruption required a carefully managed solution that prioritized safety, efficiency, and minimal downtime.
The SOLUTION
After evaluating several options with PTI, Acculift recommended a complete crane replacement that would provide long-term reliability, improved safety features, and enhanced operator control.

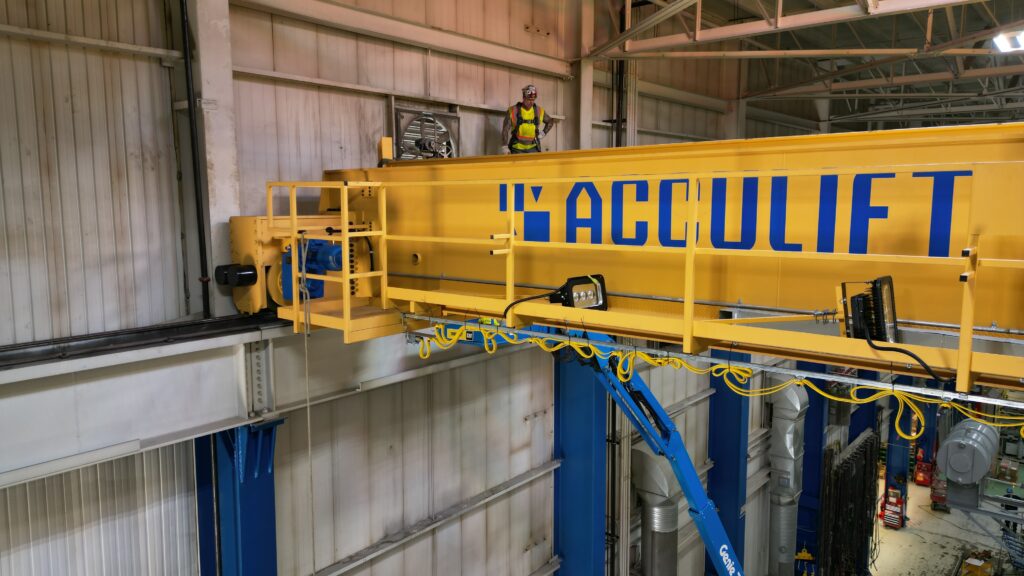

Acculift assumed responsibility for project management, coordinating the crane design, manufacturing, removal of the existing equipment, installation of the new system, load testing, and final commissioning. This ensured a single point of accountability throughout every stage of the project, from design through commissioning.

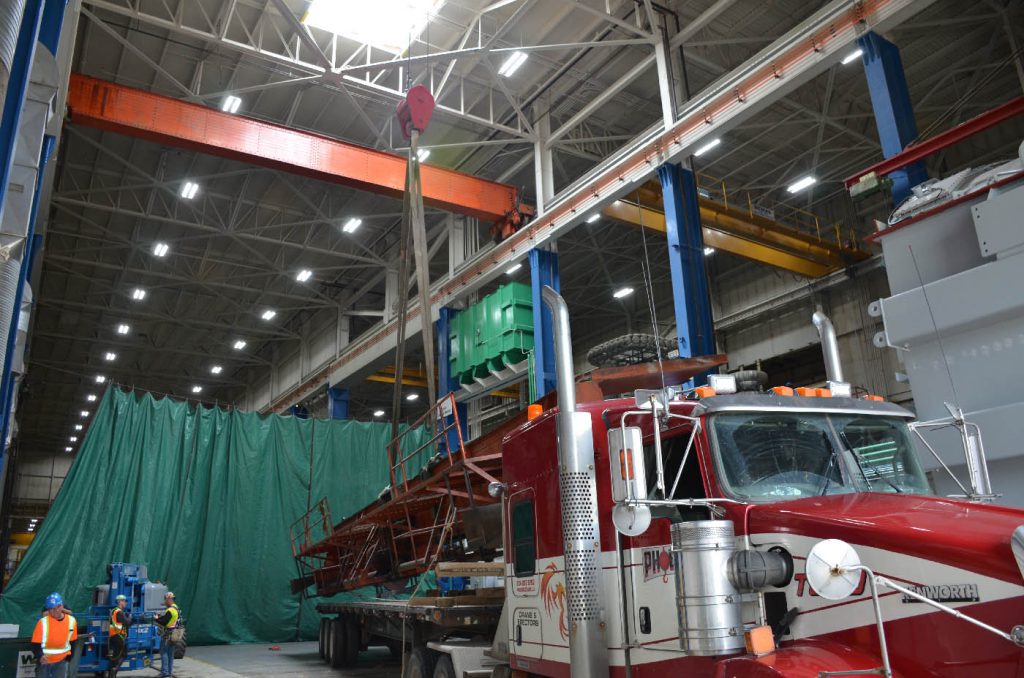

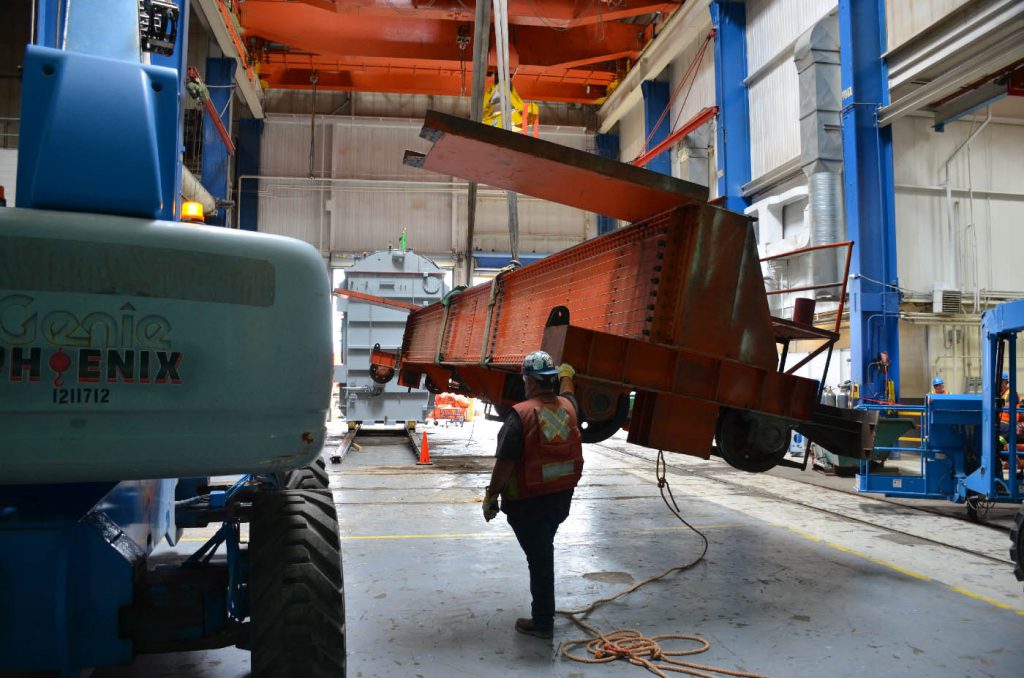

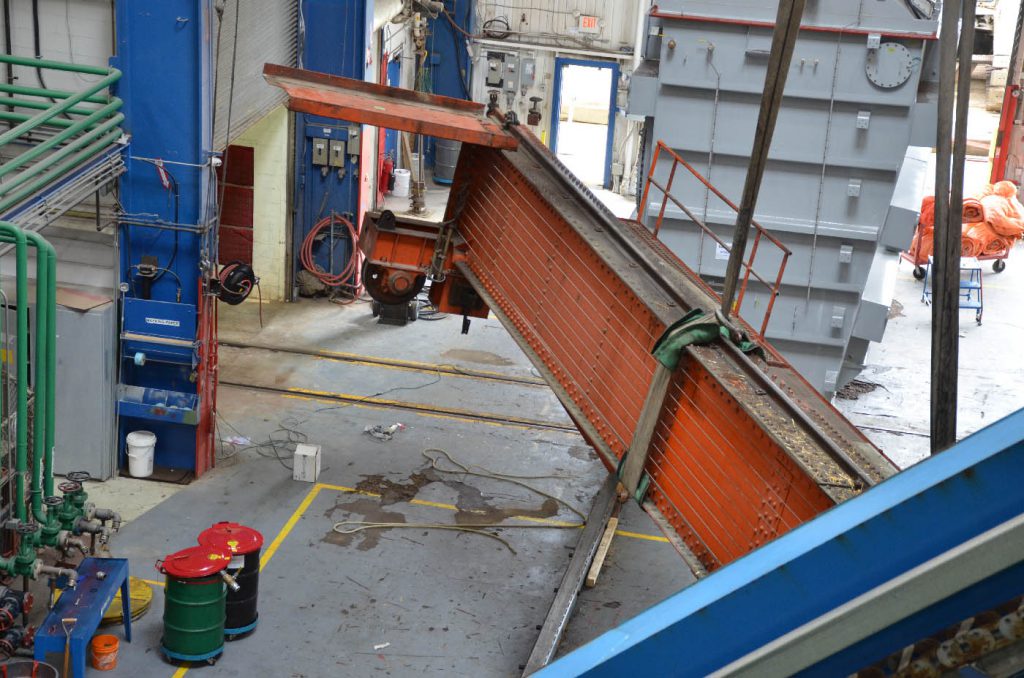

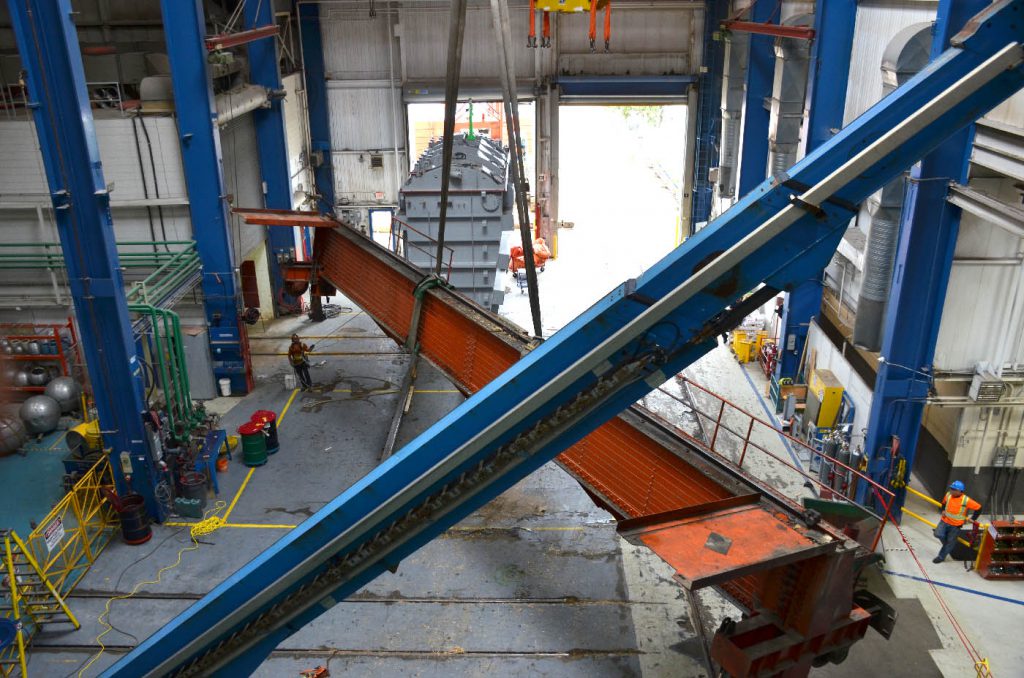

To execute the removal and installation, Acculift partnered with Phoenix Crane, whose experienced operators and crew played a critical role throughout the project. After sections of the roof were removed, the crawler crane was positioned outside the facility and used to lift, rotate, and lower the existing crane components onto waiting transport trucks.

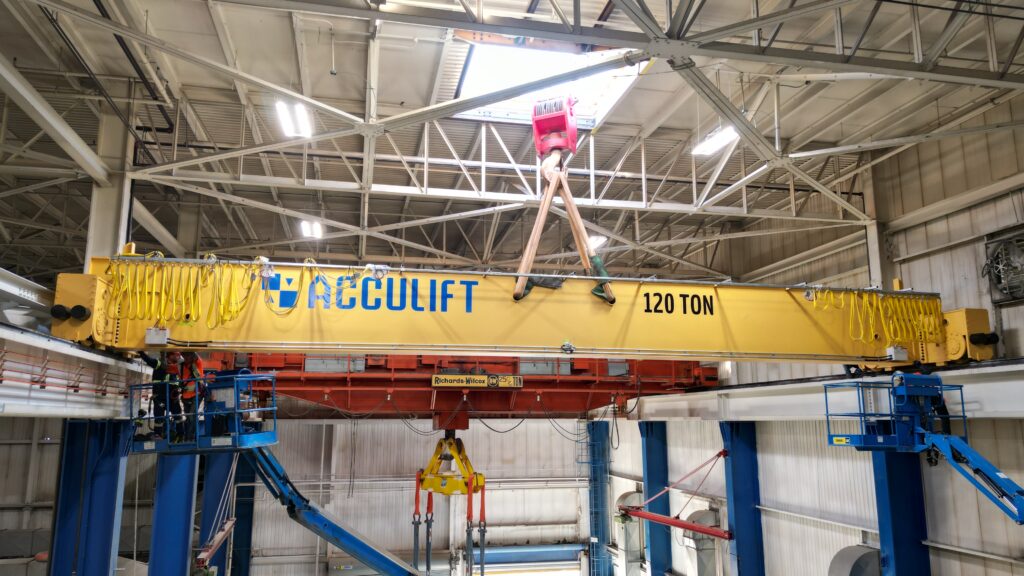

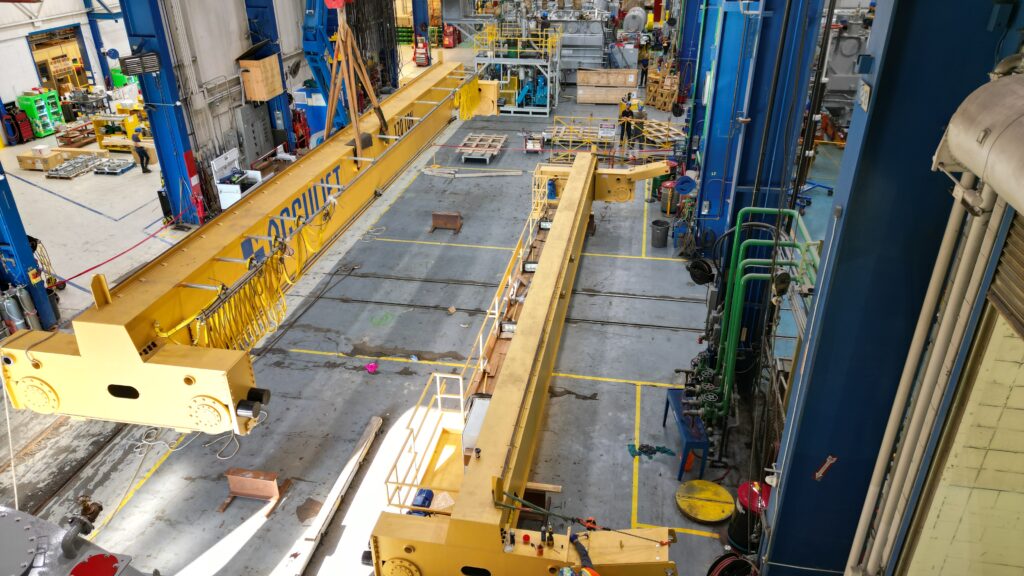

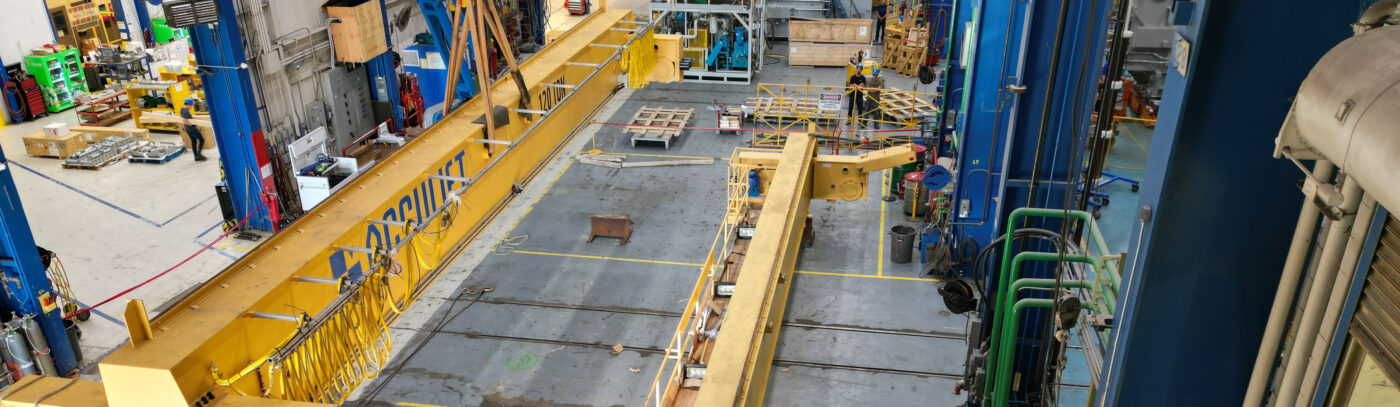

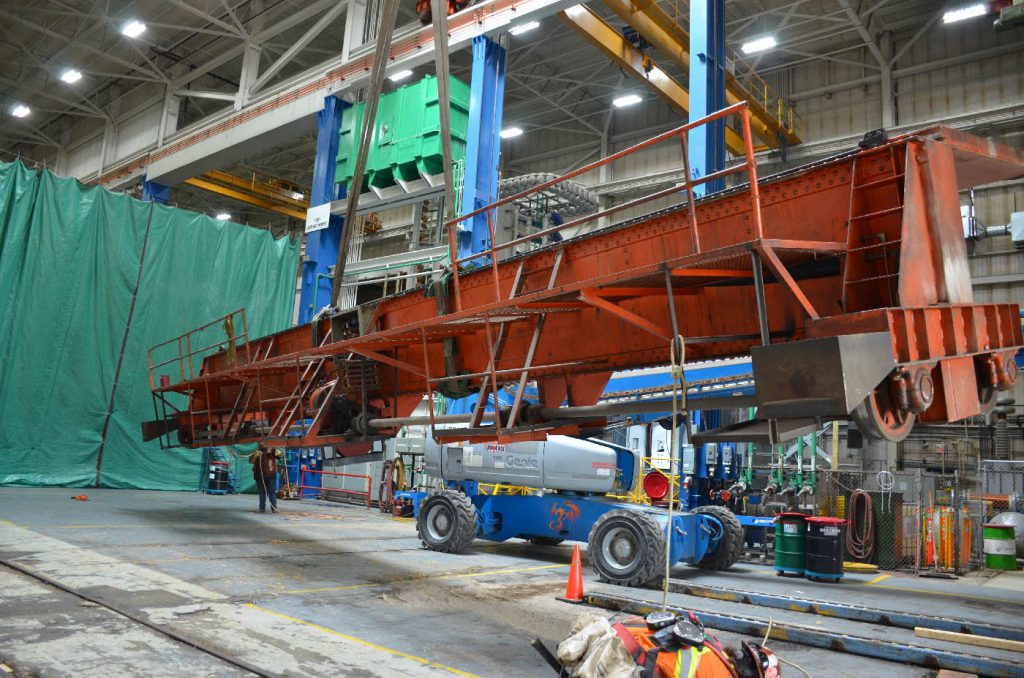

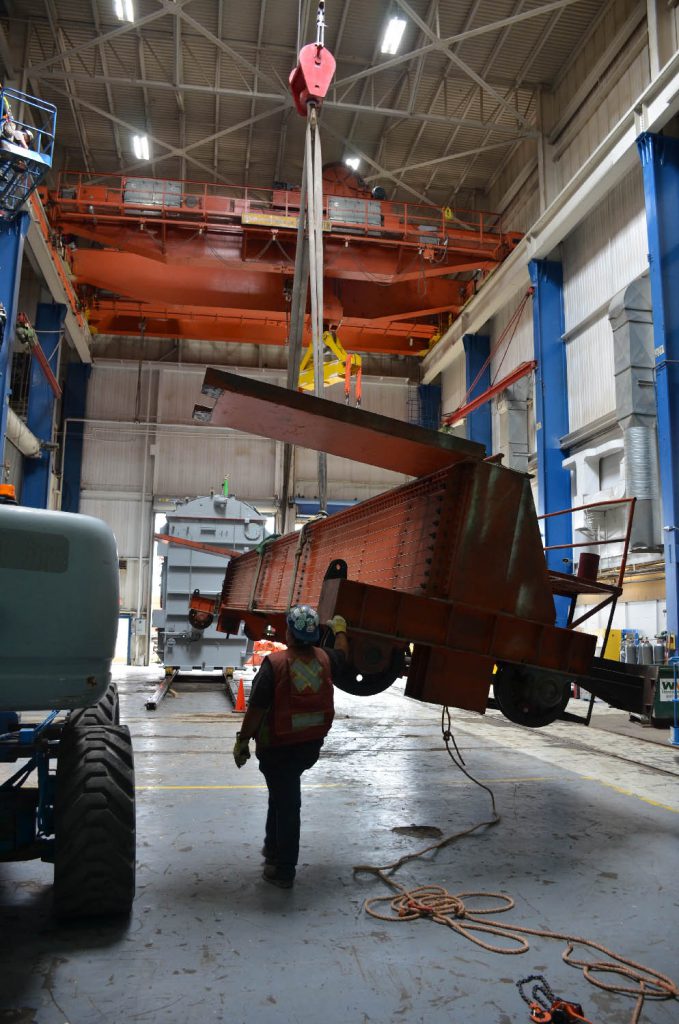

During installation of the new crane, the process was carefully reversed. New bridge girders were lifted into the building, rotated into position, and installed onto the existing runway system.
As with many large-scale retrofit projects, unexpected challenges arose. Small support angles along the runway structure created clearance issues that prevented the new bridge from travelling freely. Acculift’s team quickly identified the issue, developed a solution, and implemented the necessary modifications to ensure proper crane operation without impacting the project schedule.

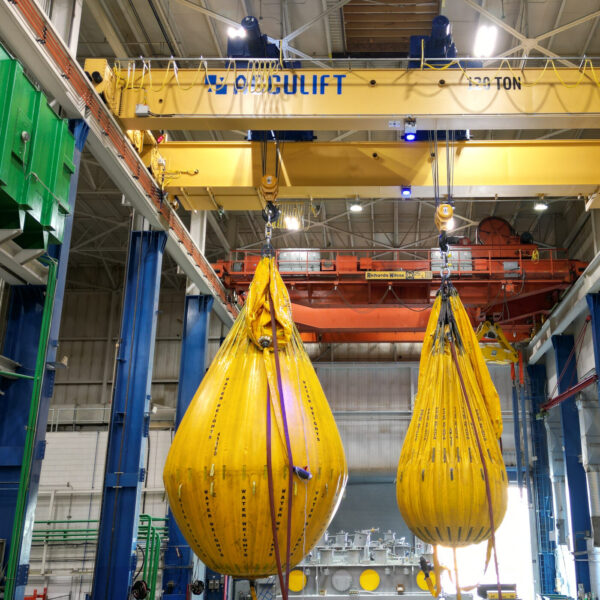

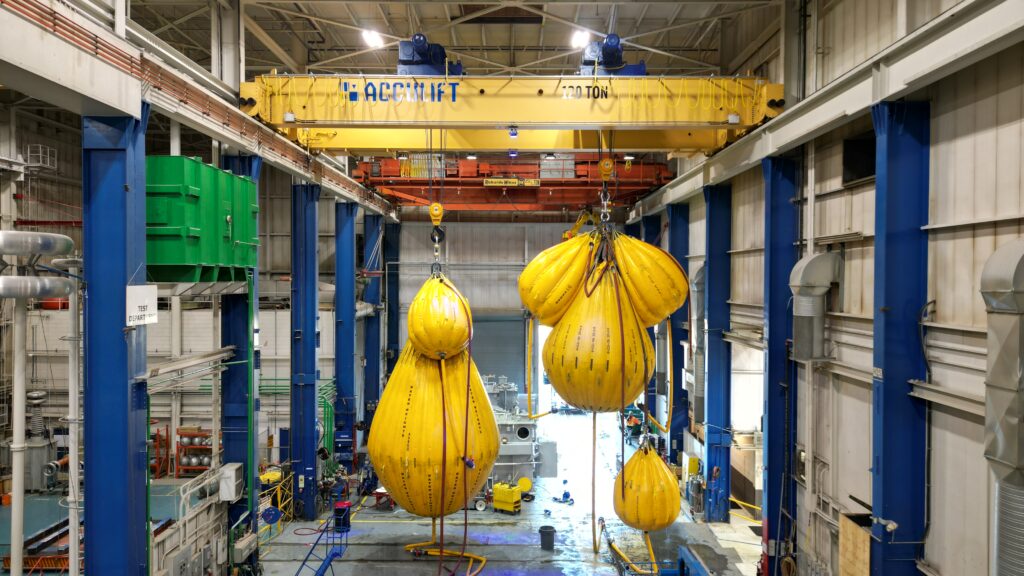

Following installation, the crane underwent comprehensive load testing using water bag test weights before being commissioned for service.
